HAUSE SEWER NETWORKsewers@hause.ca403-679-3100
TrenchlessSewer.ca
The atlas

Every trenchless method compared

Trenchless pipe methods compared side by side: typical sizes, run lengths, line and grade accuracy, ground, access pits and what each leaves behind.

Short answer

Trenchless methods differ in four ways that matter: the sizes and run lengths they handle, how accurately they hold line and grade, the ground they tolerate, and the access they need. Lining and bursting work inside an existing pipe; directional drilling, auger boring, pipe ramming, microtunnelling and moling make a new hole, and only laser-guided microtunnelling and pipe jacking hold gravity-sewer grades closely.

Key takeaways
  • Size ranges overlap widely; accuracy, ground and access usually decide between methods.
  • Microtunnelling and pipe jacking can hold line and grade to within about 25 mm; most other new-path methods are closer to ±1% of the bore length.
  • Directional drilling handles long runs and curves but struggles to hold a flat gravity grade.
  • Bursting and slip lining need a dig at every service connection; lining reopens connections from inside.
  • Most figures here come from the Iowa SUDAS design manual and ASTM scopes and are typical ranges, not hard limits.

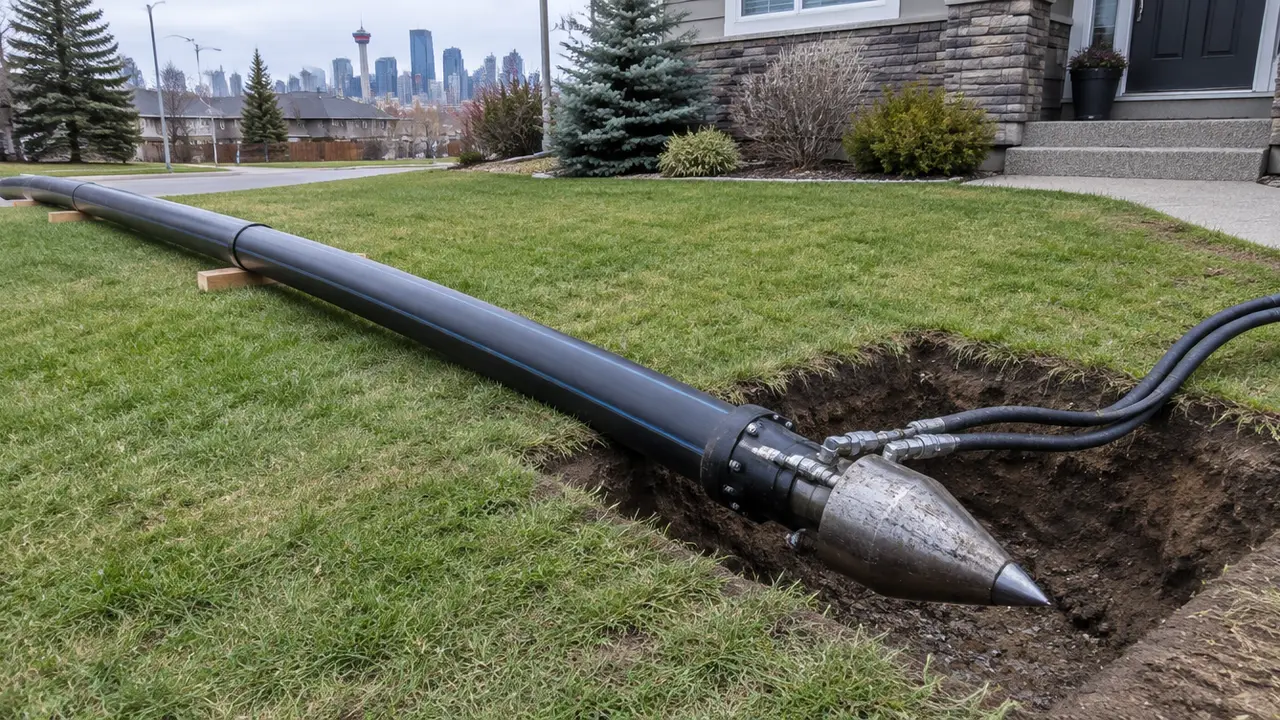

A fused HDPE pipe and bursting head at an entry pit on a lawn
IllustrationPipe bursting: a cone-shaped head splits the old pipe while pulling the new fused HDPE pipe in behind it.
Nine trenchless methods in one cutaway languageA plate of nine small cutaways drawn the same way: soil, a turf line, pits as dark voids, the old pipe in clay brown and new pipe in the accent colour. Cured-in-place lining is installed through a cleanout and cured against the old wall. Slip lining pulls a smaller pipe in from an insertion trench. Close-fit liners go in folded and are rounded tight. Coatings spray a thin film. Pipe bursting breaks the old pipe outward while new pipe follows. Pipe reaming grinds the old pipe and carries it away in slurry. Directional drilling steers an arc from surface to surface. Auger boring and ramming drive a steel casing between two pits. Microtunnelling jacks pipe behind a laser-guided boring machine between two shafts. ACCESS: CLEANOUT OR MANHOLE CIPP LININGrenews · resin tube cured inside ANNULUS GROUTED AFTER SLIP LININGrenews · smaller pipe inside CLOSE-FITrenews · folded pipe rounded THIN FILM · NOT A NEW PIPE COATINGSrenews · epoxy or spray film PIPE BURSTINGreplaces · old pipe broken outward CUTTINGS OUT IN SLURRY PIPE REAMINGreplaces · old pipe ground up ENTRY + EXIT AT SURFACE DIRECTIONAL DRILLINGnew path · steered arc CARRIER PIPE GOES INSIDE AUGER / RAMMINGnew path · steel casing driven MICROTUNNELLINGnew path · laser-guided, jacked
Fig. 1Nine trenchless methods drawn in the same cutaway: where the access is, what the tool does, and what is left in the ground.

01 /How should trenchless methods be compared?

Compare them on the constraints your job cannot move. A gravity sewer needs a steady fall, so accuracy matters more than speed. A road crossing needs a casing strong enough for traffic loads, so the method must suit steel pipe. A lateral with four branches needs a plan for four connections. A river crossing needs length. Pick the constraint first, and the list of candidates shrinks quickly.

Nine trenchless methods in one cutaway languageA plate of nine small cutaways drawn the same way: soil, a turf line, pits as dark voids, the old pipe in clay brown and new pipe in the accent colour. Cured-in-place lining is installed through a cleanout and cured against the old wall. Slip lining pulls a smaller pipe in from an insertion trench. Close-fit liners go in folded and are rounded tight. Coatings spray a thin film. Pipe bursting breaks the old pipe outward while new pipe follows. Pipe reaming grinds the old pipe and carries it away in slurry. Directional drilling steers an arc from surface to surface. Auger boring and ramming drive a steel casing between two pits. Microtunnelling jacks pipe behind a laser-guided boring machine between two shafts. ACCESS: CLEANOUT OR MANHOLE CIPP LININGrenews · resin tube cured inside ANNULUS GROUTED AFTER SLIP LININGrenews · smaller pipe inside CLOSE-FITrenews · folded pipe rounded THIN FILM · NOT A NEW PIPE COATINGSrenews · epoxy or spray film PIPE BURSTINGreplaces · old pipe broken outward CUTTINGS OUT IN SLURRY PIPE REAMINGreplaces · old pipe ground up ENTRY + EXIT AT SURFACE DIRECTIONAL DRILLINGnew path · steered arc CARRIER PIPE GOES INSIDE AUGER / RAMMINGnew path · steel casing driven MICROTUNNELLINGnew path · laser-guided, jacked
Fig. 2Nine methods in one cutaway language. The differences to look for are where the access is, what the tool does to the old pipe or the ground, and what stays behind.

The numbers below come mainly from Chapter 14 of the Iowa Statewide Urban Design and Specifications (SUDAS) design manual, a public engineering manual with unusually specific ranges for each method, and from the scopes of the relevant ASTM practices. They are typical working ranges, converted to metric and rounded. Equipment keeps improving, and specialist contractors regularly work outside them, so treat an out-of-range job as a reason to ask questions, not as impossible.

02 /How do the renewal and replacement methods compare?

Methods that work inside an existing pipe
MethodSize rangeBore afterwardsConnectionsMain limit
CIPP, inverted50–2,743 mm (ASTM F1216: 2–108 in)Slightly smallerReopened from insideNeeds an open, reasonably round path
CIPP, pulled in50–2,438 mm (F1743: 2–96 in)Slightly smallerReopened from insideSame; a calibration hose presses it out
CIPP, UV-cured glass liner100–1,830 mm (F2019: 4–72 in)Slightly smallerReopened from insidePulled in, cured by UV light
Slip liningMost economical on larger pipeSmaller; annulus groutedDug up, new wyeCapacity loss
Close-fit linersProduct specificSlightly smallerRobotic or dugDeclining use in cold climates
CoatingsF2831: 13–914 mm metallic pressure pipeBarely changesCoated throughNot structural
Pipe bursting50–914 mm (SUDAS: 2–36 in)Same or up to about three sizes largerDug up firstHeave, nearby services, sags, rock
Pipe splittingSimilar to burstingSame or largerDug up firstFor ductile iron, steel and plastic
Pipe reamingProduct specificSame or largerDug upNon-metallic hosts only; slurry

SUDAS gives the normal bursting length as the 300 to 400 feet between manholes, about 90 to 120 m, and notes that upsizing of up to three pipe diameters or more has been done, with size-for-size the most common. It also notes that the new polyethylene pipe stretches during the pull and should relax for at least 24 hours before services are reconnected, a point that applies equally to polyethylene slip liners.

03 /How do the new-path methods compare?

Methods that make a new hole (SUDAS Chapter 14, converted and rounded)
MethodCommon sizesTypical lengthAccuracyGround
Mini directional drillingUp to 254 mm (10 in)Under about 180 m (600 ft)150–300 mm (6–12 in)Clays, silts, sands ideal
Large directional drilling305–1,524 mm (12–60 in)Over 600 m (2,000 ft) possibleAbout ±1% of lengthSlower and less accurate in gravel and rock
Auger boring203–914 mm (8–36 in)53–69 m typical; over 180 m possible±1%; steered ±0.1% verticallyBoulders up to a third of the casing; not rock
Pipe ramming51–1,397 mm (2–55 in)Under 46 m; up to about 91 mNon-steerable, about ±1%Most ground except solid rock
Slurry boring51–305 mm (2–12 in)12–23 m±1% up to about 18 mMost ground; some owners prohibit it
Impact molingUp to 152 mm (6 in)12–18 mNo control once startedSoft to medium compressible soil
Microtunnelling254–3,048 mm (10–120 in)Long drives economicalWithin about 25 mmWide range; boulders to 20–30% of diameter
Pipe jacking (man-entry)1,067 mm (42 in) and upExtended with intermediate jacking stationsWithin about 25 mmAlmost all ground with the right shield
Line and grade accuracy of new-path methods over a 60 m boreA bar chart of the possible error in position over a 60 metre bore, using the tolerances in the Iowa SUDAS design manual. Impact moling cannot be steered and is not used for sewers. Pipe ramming, unsteered auger boring and directional drilling are typically within about one percent of the bore length, plus or minus 600 millimetres over 60 metres. Steered auger boring holds about a tenth of a percent vertically, 60 millimetres. Microtunnelling and pipe jacking can hold within about 25 millimetres. A reference line marks the 600 millimetres of total fall a 1 percent gravity sewer has over the same 60 metres. POSSIBLE ERROR AT THE FAR END OF A 60 m BORE (± mm) 0150300450600 IMPACT MOLINGnot steerable · not used for sewersNO LINE OR GRADE CONTROL ONCE STARTEDPIPE RAMMINGnon-steerable · ≈ ±1% of length±600AUGER BORINGunsteered · ≈ ±1% of length±600DIRECTIONAL DRILLING≈ ±1% of length±600STEERED AUGER (VERTICAL)≈ ±0.1% of length±60MICROTUNNEL / PIPE JACKINGwithin ≈ 25 mm (1 in)±25 TOTAL FALL OF A 1% SEWER OVER 60 m = 600 mm TOLERANCES: IOWA SUDAS DESIGN MANUAL CH. 14 · ARITHMETIC ONLY · REAL RESULTS DEPEND ON GROUND AND OPERATOR
Fig. 3The accuracy column applied to a 60 m bore: ±600 mm for methods held to about one percent of length, against the 600 mm of fall a 1% sewer has over the same run.

The accuracy column is the one owners overlook. A bore that can wander by one percent of its length is fine for a water line, which runs under pressure and does not care about small dips. For a gravity sewer at one or two percent slope, the same wander can eat most of the fall. SUDAS gives the example of a 12-inch sewer bored 200 feet on a 1% grade: with tolerances of ±0.2%, common for gravity sewers, the job would likely need an oversized casing or microtunnelling. Loosen the tolerance and a steered auger bore may do. The detail is in directional drilling for sewer lines and auger boring and pipe ramming.

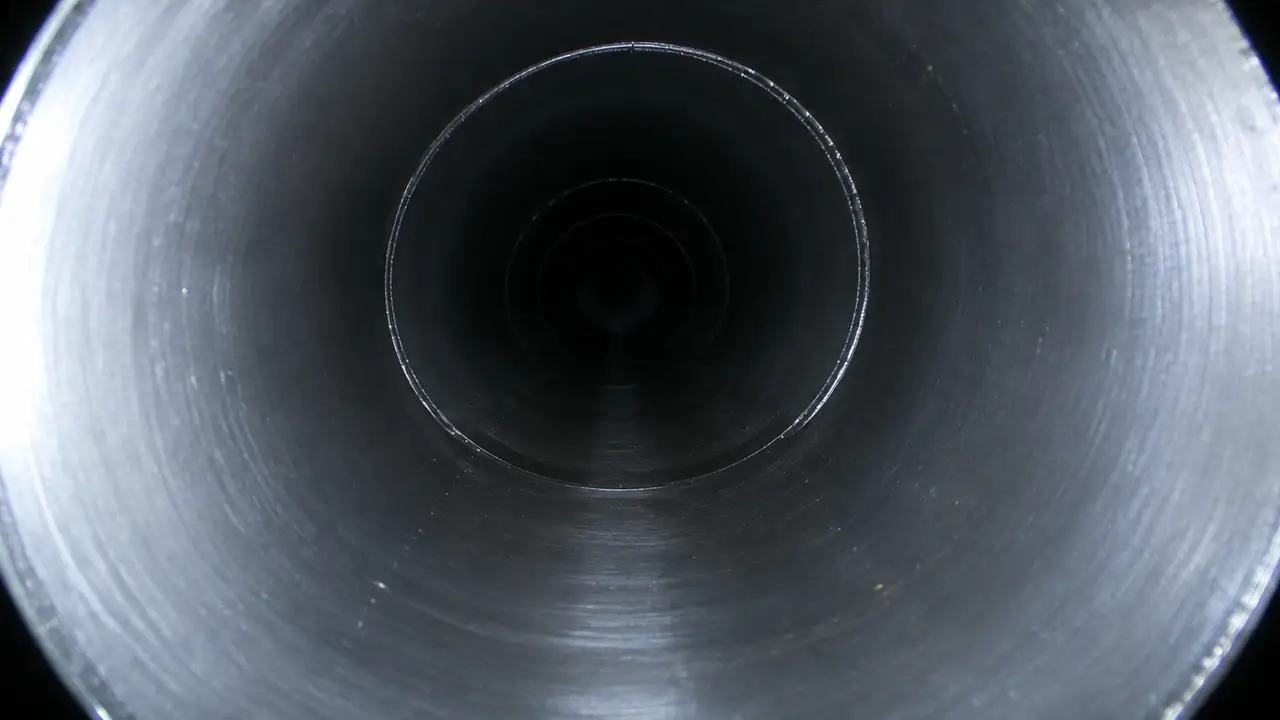

Sewer camera view of a new black HDPE pipe
IllustrationA new HDPE pipe pulled in by pipe bursting: continuous, fused and jointless.

04 /What access does each method need?

Access and excavation by method
MethodAccess at the endsExtra digsRoom at the surface
CIPP liningCleanout, manhole or one small pitUsually noneTruck, boiler or UV train, wet-out area
Slip liningInsertion trench and receiving pitOne per serviceFused pipe laid out in a line
Bursting and splittingLaunch and receiving pitsOne per serviceFused pipe laid out; puller
ReamingDrill rig set-up and a pitOne per serviceRig, fluid and cuttings handling
Directional drillingRig at the surface; exit pointConnection digsRig plus full pipe string length
Auger boringLong bore pit and receiving pitNoneCasing sections, crane
Pipe rammingLaunch pit with rails and receiving pitNoneCasing sections, compressor
MicrotunnellingJacking shaft and reception shaftNoneControl unit, slurry separation, crane
Impact molingTwo small pitsNoneCompressor

SUDAS describes an auger-boring pit as typically 26 to 40 feet long and 8 to 12 feet wide, about 8 to 12 m by 2.5 to 3.5 m, which surprises owners who picture a small hole. Large directional drilling set-ups can occupy an area as big as 150 by 250 feet. Put your own pit sizes into the Dig vs Trenchless Disruption Calculator to see how they compare with a trench.

05 /Which methods suit gravity sewers?

For renewal and replacement, any method that keeps the pipe open and round works on a gravity sewer, with the caveat that it keeps the existing grade. For new gravity lines, the short list is short.

  • Microtunnelling and pipe jacking are built for it: laser-guided, steerable, and within about 25 mm of line and grade.
  • Steered auger boring can hold about ±0.1% vertically, and an oversized casing lets the carrier pipe be adjusted to grade on chocks.
  • Pipe ramming and unsteered auger boring install a casing roughly on line; the carrier is then set to grade inside it, which needs an oversized casing when tolerances are tight.
  • Directional drilling can install a gravity line with generous fall, but SUDAS notes it can be difficult at small slopes and may not suit gravity pipelines.
  • Moling and slurry methods are not used where accuracy matters, such as sanitary sewers.

06 /How do I narrow the list for my job?

  1. Name the job

    Renew, replace, or new path. That removes two of the three families.

  2. Get the camera run

    For an existing pipe, condition decides whether it can be lined, burst or must be dug.

  3. Check size and length

    Compare your diameter and access spacing with the tables above.

  4. Check grade

    For a new gravity line, compare the method's accuracy with the total fall.

  5. Check the ground and surroundings

    Rock, cobbles, groundwater, nearby services and shallow cover each rule methods out.

  6. Count the digs

    Connections and pit sizes can erase the ground savings on short runs.

The Trenchless Method Finder automates those steps against the same published ranges. For individual methods, read CIPP in the trenchless family, bursting, splitting and reaming, slip lining and microtunnelling. When you have a shortlist, request quotes for more than one method.

FAQQuestions people ask

What is the most accurate trenchless method?

Laser-guided microtunnelling and pipe jacking. SUDAS says installations within about one inch (25 mm) of line and grade are possible with either.

Which trenchless method handles the longest runs?

Large directional drilling rigs, which SUDAS describes installing pipe over more than 2,000 feet, and microtunnelling drives, which become economical as length increases.

Which trenchless methods reduce pipe size?

The renewal methods: CIPP, close-fit liners and coatings slightly, slip lining more. Bursting and splitting can keep the same size or go larger.

What is the cheapest trenchless method?

For short, small-diameter bores, SUDAS calls compaction methods such as moling normally the lowest-cost option. For pipe renewal it depends on the job, and slip lining is often economical on larger pipes.

Can one job use more than one method?

Yes. A dig at a sag with lining on either side, or a burst lateral with a directionally drilled water service in the same pit, are common combinations.
